Review targeted academic assignments with the CA IPCC Contract Costing Job and Batch Costing Solutions. Built according to official Chartered Accountancy standards for the 2026-27 term, these downloadable IPCC Costing worksheets support effective daily practice for Contract Costing Job And Batch Costing Solutions.
Solved Practice Assignments for Costing
Access the complete assignment PDF for IPCC Costing below. Regular practice with these targeted academic tasks builds familiarity with standard question patterns and helps secure higher marks in final school evaluations.
CA IPCC Contract Costing Job & Batch Costing Solutions for CA IPCC Cost Accounting also includes notes, Questions and answers. CA IPCC Students please refer to the attached file for solutions for important questions which came in previous examinations for Cost Accounting and also study notes. Refer to other links too for detailed study notes/ question banks and solutions on all chapters of Cost Accounting for CA IPCC Refer to the attached file for CA IPCC Contract Costing Job & Batch Costing Solutions
Question 1. Explain the basic concepts of contract costing, including parties involved, work certification, retention money, and transfer of profit to Profit and Loss Account based on the degree of completion.
Answer: Contract costing is a method of costing used in construction and engineering industries where work is undertaken according to specific customer requirements and specifications.

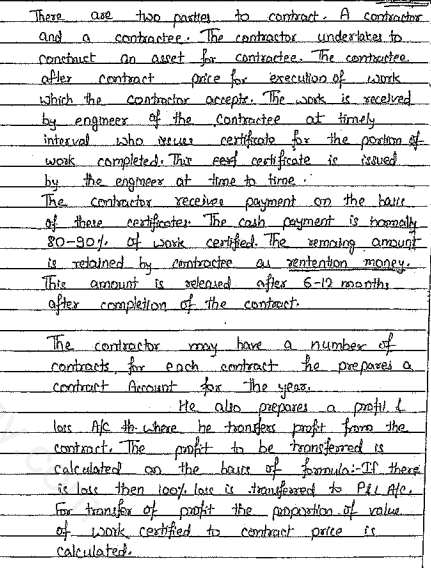

1. Parties Involved: There are two main parties - the contractor (who undertakes to construct) and the contractee (the owner for whom the asset is constructed).
2. Work Certification: The work completed is periodically inspected and certified by the architect or engineer of the contractee. This certified value is known as work certified.
3. Retention Money: A portion of the certified value (usually 10% to 20%) is retained by the contractee as security against any defects. This is released after a specified defect liability period (6 to 12 months).
4. Profit Recognition Rules:
- If work certified is less than \(25\%\) of contract price: No profit is transferred to P&L Account; entire notional profit is kept as reserve.
- If work certified is between \(25\%\) and less than \(50\%\): \(\frac{1}{3} \times \text{Notional Profit} \times \frac{\text{Cash Received}}{\text{Work Certified}}\) is transferred to P&L.
- If work certified is \(50\%\) or more: \(\frac{2}{3} \times \text{Notional Profit} \times \frac{\text{Cash Received}}{\text{Work Certified}}\) is transferred to P&L.
- If the contract is near completion: Profit is calculated using estimated total profit and the proportion of work certified or cost incurred.
In simple words: Contract costing tracks costs and profits for large projects over multiple periods, recognizing profit cautiously based on how much work has been certified and paid for.
Exam Tip: Memorize the profit transfer fractions (\(0\), \(\frac{1}{3}\), and \(\frac{2}{3}\)) corresponding to the percentage ranges of work certified to contract price (\(<25\%\), \(25\%-50\%\), \(\ge 50\%\)).
Question 2. A contract has a contract price of Rs. 4,00,000. During the year, material issued is Rs. 1,15,500, wages paid Rs. 28,800, plant hire Rs. 38,000, and direct expenses Rs. 63,000. Work certified is Rs. 3,90,000 and cash received is Rs. 3,51,000. Prepare the Contract Account and calculate the profit to be transferred to P&L Account.
Answer:
Percentage of work certified = \(\frac{3,90,000}{4,00,000} \times 100 = 97.5\%\)
Since completion is near completion (\(>90\%\)), estimated profit formula applies, or based on cash received:
Profit to P&L = \(\text{Notional Profit} \times \frac{\text{Cash Received}}{\text{Work Certified}} \times \frac{2}{3}\)
Notional Profit = Total Credit - Total Debit = \(3,90,000 - (1,15,500 + 28,800 + 38,000 + 63,000)\) = Rs. \(1,44,700\)
Profit transferred = \(1,44,700 \times \frac{3,51,000}{3,90,000} \times \frac{2}{3} =\) Rs. \(86,820\).
In simple words: First find the net notional profit by subtracting costs from the value of work certified, then apply the completion formula to determine how much profit to credit to the P&L account.
Exam Tip: Always check if wages and expenses have outstanding or prepaid adjustments before transferring them to the Contract Account.
Question 3. Prepare Contract Account for a contract where material issued is Rs. 1,75,000, labour Rs. 55,000, miscellaneous expenses Rs. 2,000, and plant depreciation Rs. 4,000. Work certified is Rs. 2,00,000 and work uncertified is Rs. 7,000. Contract price is Rs. 4,50,000.
Answer:
Percentage of work certified = \(\frac{2,00,000}{4,50,000} \times 100 = 44.44\%\)
Since work certified is between \(25\%\) and \(50\%\), profit transferred to P&L = \(\frac{1}{3} \times \text{Notional Profit} \times \frac{\text{Cash Received}}{\text{Work Certified}}\).
Notional Profit = Credit side (Work certified Rs. \(2,00,000\) + Work uncertified Rs. \(7,000\)) - Debit side (Materials Rs. \(1,75,000\) + Labour Rs. \(55,000\) + Expenses Rs. \(2,000\) + Depreciation Rs. \(4,000\) = Rs. \(2,36,000\))
Notional Profit = \(2,07,000 - 2,36,000\) = Rs. \(26,400\).
Profit to P&L = \(26,400 \times \frac{1}{3} \times \frac{\text{Cash Received}}{\text{Work Certified}}\).
In simple words: When completion is between 25 percent and 50 percent, exactly one-third of the notional profit adjusted for cash collection is moved to the profit and loss account.
Answer:
Materials consumed = Purchases Rs. \(3,00,000 -\) Closing Stock Rs. \(50,000\) = Rs. \(2,50,000\)
Depreciation on plant = Calculated based on usage period.
Notional profit is computed by comparing total costs against work certified and uncertified.
Profit transferred to P&L is calculated using the formula: \(\text{Notional Profit} \times \frac{2}{3} \times \frac{\text{Cash Received}}{\text{Work Certified}}\).
In simple words: Deduct closing stock from purchases to find net material cost, then build the contract account to derive the profit for the year.
Exam Tip: Always deduct closing stock of materials and include closing prepaid/outstanding expenses correctly before calculating notional profit.
Question 5. Calculate the deductible depreciation on plant and machinery used across multiple periods where plant is returned or new plant is purchased partway through the year.
Answer:
When plant is used for a fraction of the year, depreciation is prorated based on the exact number of months or days used:
Depreciation = \(\text{Original Cost} \times \text{Rate} \times \frac{\text{Months Used}}{12}\)
For plant returned before year-end, calculate depreciation up to the date of return and then revalue or remove the remaining book value.
In simple words: Calculate depreciation strictly for the exact months the machinery was active on the contract site.
Exam Tip: Pay close attention to dates when plant is introduced or returned to site to ensure accurate time-apportioned depreciation.
Question 6. Explain the treatment of Escalation Clause in contract costing with a suitable example.
Answer:
An escalation clause is inserted in contract agreements to cover potential increases in the prices of materials and rates of labour. Under this clause, if costs rise beyond a stipulated percentage, the contract price is increased proportionately, ensuring the contractor does not suffer unexpected losses due to inflation.
In simple words: An escalation clause protects the contractor by passing approved cost increases due to inflation onto the contractee.
Exam Tip: Verify whether the price increase applies to all costs or only to specific elements like materials and wages as specified in the contract agreement.
Question 7. Explain the treatment of estimated losses on uncompleted contracts.
Answer:
Unlike anticipated profits—which are recognized cautiously—any anticipated or estimated loss on a contract must be provided for in full immediately in the Profit and Loss Account, regardless of the stage of completion of the contract, following the conservative accounting principle.
In simple words: Expected profits are deferred, but expected losses must be fully recognized right away.
Exam Tip: Never carry forward an estimated loss to future periods as an asset; debit it immediately to the Profit and Loss Account.
Chartered Accountancy IPCC Costing Assignments for Contract Costing Job And Batch Costing Solutions
Chapter Practice Questions for IPCC Costing
Review targeted chapter assignments for IPCC Costing Contract Costing Job And Batch Costing Solutions. Built according to official Chartered Accountancy guidelines, these downloadable problem sets help students build accuracy and prepare effectively for school tests.
Why Practice IPCC Costing Assignments?
- Exam Alignment: Questions strictly follow contemporary Chartered Accountancy sample papers and grading schemes.
- Comprehensive Coverage: Features objective drills, case studies, and structured descriptive problems for Contract Costing Job And Batch Costing Solutions.
- Pacing & Precision: Regular problem-solving builds critical calculation speed and test-taking accuracy.
Steps to Complete Contract Costing Job And Batch Costing Solutions Assignments Successfully
- Initial Reading: Begin by reading the NCERT book for IPCC Costing to build a baseline understanding.
- Independent Testing: Attempt assignment questions unassisted, then verify work using provided answer keys.
- Supplementary Aids: Leverage revision notes and worksheets whenever you encounter difficult topics.
FAQs
You can download free PDF assignments for IPCC Costing Contract Costing Job And Batch Costing Solutions from StudiesToday.com. These practice sheets have been updated for the 2026-27 session covering all concepts from latest NCERT textbook.
Yes, our teachers have given solutions for all questions in the IPCC Costing Contract Costing Job And Batch Costing Solutions assignments. This will help you to understand step-by-step methodology to get full marks in school tests and exams.
Yes. These assignments are designed as per the latest Chartered Accountancy syllabus for 2026. We have included huge variety of question formats such as MCQs, Case-study based questions and important diagram-based problems found in Contract Costing Job And Batch Costing Solutions.
Practicing topicw wise assignments will help IPCC students understand every sub-topic of Contract Costing Job And Batch Costing Solutions. Daily practice will improve speed, accuracy and answering competency-based questions.
Yes, all printable assignments for IPCC Costing Contract Costing Job And Batch Costing Solutions are available for free download in mobile-friendly PDF format.
